WKL H₂ pipeline construction project

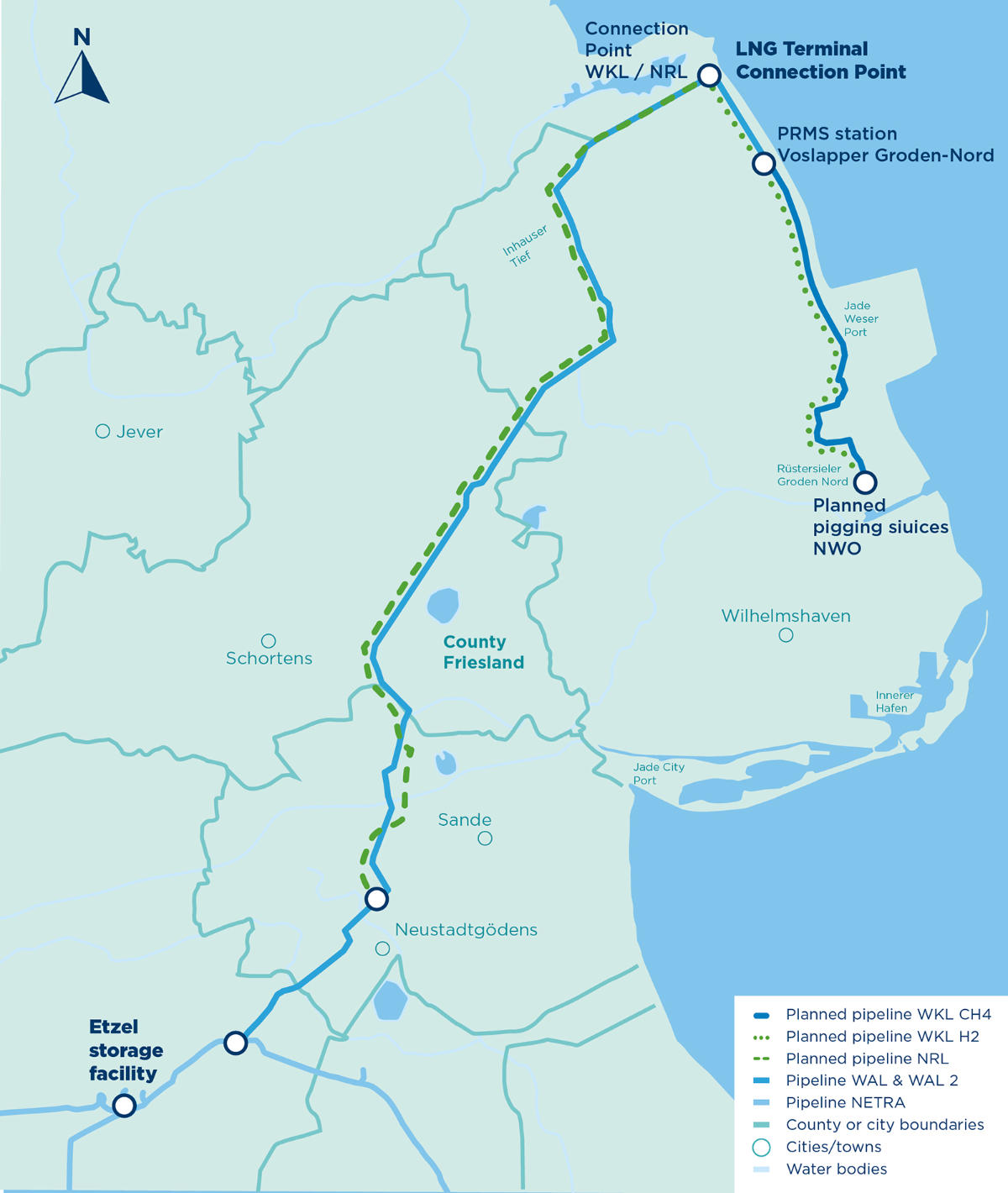

Wilhelmshaven Coast Line – the starting point for hydrogen transport from the north to the west

The Wilhelmshaven Coast Line along the coast of Wilhelmshaven connects the important northern import corridor as well as national producers and consumers of hydrogen.

Along with other national gas network operators, OGE has been tasked by the Federal Network Agency and the German government to develop a Germany-wide hydrogen core network. Together with the North Sea Ruhr Link, the Wilhelmshaven Coast Line will be a central transmission route for hydrogen from the northern coastal regions to the north-west of Germany.

The Wilhelmshaven Coast Line will run for some 11 kilometres from the north to the south of Wilhelmshaven almost exclusively through industrial areas.

Facts and figures

12 KM

Pipeline length

buried

Type of installation

100 bar

Design pressure

DN 1000

Pipe diameter

Q4 2026

Construction

Q4 2027

Completion

Planning status

According to plans for the hydrogen core network, the Wilhelmshaven Coast Line for H2 must be completed and commissioned by the end of 2027.

The project is currently undergoing planning approval, with the planning decision expected by the end of 2025.

According to current plans, the Wilhelmshaven Coast Line is scheduled to enter the construction phase in 2026.
